HomeMars colonization hub › How could humans really colonize Mars?

Pillar guide

How could humans really colonize Mars?

The route to a permanent settlement is not one heroic flight. It is a sequence of risk-reduction, cargo, infrastructure and institution-building missions.

  • Evidence-led
  • Original public guide
  • Updated 4 August 2026

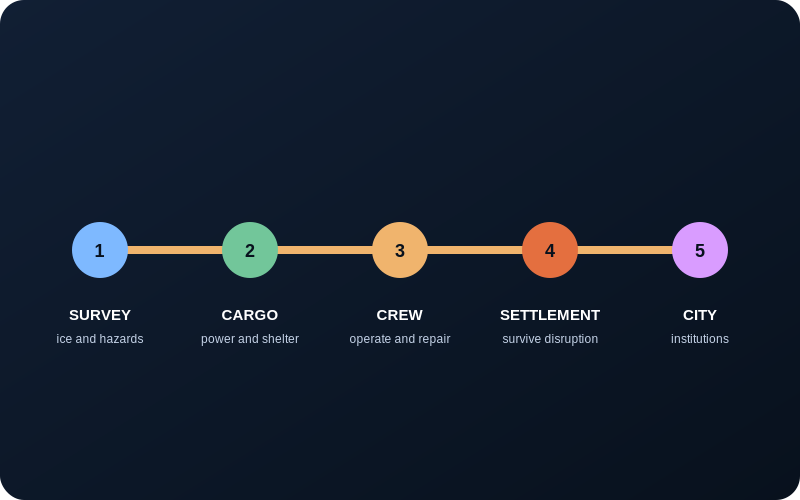

Roadmap from robotic surveys and cargo missions to a permanent Mars settlement and city
Original Delta-Sierra explanatory diagram. It summarizes relationships, not a finalized mission architecture.
Stage 0Robotic reconnaissance and site certification.
Stage 1Uncrewed cargo and power before people.
Stage 2A crewed base designed to survive failures.
Stage 3Repeated growth toward settlement and city.

How would a colony on Mars actually be built, step by step?

A credible Mars colony would be built in layers rather than by sending a large population at once. The sequence starts with site reconnaissance, uncrewed cargo, power generation, water access, communications and protected living volume. The first crews arrive only after critical infrastructure has been tested. Growth becomes rational after the settlement demonstrates maintenance, redundancy, medical capability, recycling, agriculture and the ability to manufacture an increasing share of critical parts locally.

The decisive question is therefore not “how many people can a spacecraft carry?” but “how many people can the surface infrastructure keep alive when several failures occur at the same time?” The roadmap below follows that logic and separates demonstrated capabilities, illustrative sizing examples and still-prospective settlement architectures.

Editorial status: original English article by David Salvan’s Delta-Sierra project. Scientific claims are linked to institutional sources; prospective settlement choices are identified as analysis rather than fact.

The central answer

Humans could colonize Mars only by building the destination before depending on it

A credible colonization sequence begins with a simple rule: the first crew should not be asked to create every life-critical capability after landing. Power, communications, navigation aids, spare habitats, surface mobility and at least part of the resource-processing chain should arrive first and prove that they work in the actual Martian environment. The first human landing would then connect, inspect and expand an existing robotic foothold rather than improvise a base from cargo scattered across an uncertain landing ellipse.

This approach sounds cautious because it is. Mars offers no rapid rescue. Depending on orbital geometry, a one-way message takes roughly three to twenty-two minutes, and superior conjunction can disrupt communications for extended periods. A failed valve, medical crisis or software fault cannot be handed to Earth in real time. The settlement must carry expertise, procedures, diagnostic tools and authority locally.

Important distinction. NASA currently develops an architecture for human exploration from the Moon toward Mars. SpaceX describes a transport system and the objective of a self-growing base or civilization. Neither organization has demonstrated the complete surface, life-support, industrial and political system required for permanent settlement.

Stage 0: choose the purpose before choosing the hardware

“Go to Mars” is not a mission requirement. A short scientific expedition, a repeatedly occupied base and a permanent settlement require different cargo, crew, risk limits and legal arrangements. A short-stay architecture can accept deep dependence on pre-positioned supplies. A settlement architecture must invest early in repair, resource extraction, storage and workforce continuity, even when those systems increase initial mass.

The purpose also determines ethical constraints. A landing site valuable for accessible ice may also be scientifically sensitive. Human activity introduces heat, chemicals and terrestrial microbes. Site selection must balance engineering access with planetary-protection rules and the preservation of uncontaminated regions for research.

Stage 1: map and certify candidate settlement zones

The best landing site is not simply the flattest plain. It must combine safe entry, descent and landing; manageable altitude; useful sunlight; tolerable seasonal temperatures; access to subsurface water ice; communications geometry; traversable terrain and distance from hazards. NASA’s Subsurface Water Ice Mapping work has identified regions where ice may lie within about a meter of the surface. That is a powerful lead, not a guarantee that a colony can immediately mine clean water at industrial scale.

Before humans depend on a site, robotic missions would need to drill, analyze the ice and soil, measure dust behavior, monitor weather over multiple seasons and test excavation equipment. They would also need to determine whether local material can be processed into shielding, landing pads, roads or construction feedstock. The useful question is not “Is there water?” but “At what depth, purity, temperature, mechanical strength and energy cost can water be delivered every day?”

Stage 2: land power, communications and shelter first

Early cargo missions should establish an energy island before the crew arrives. Solar power is mature and scalable, but Mars dust and seasonal light variation make storage and cleaning central design issues. Fission surface power offers continuous output independent of sunlight, yet it introduces reactor transport, deployment, exclusion-zone and maintenance challenges. A settlement architecture may ultimately use both: solar arrays for scalable daytime production and fission units for dependable baseload power.

Habitats should be landed, checked for leakage and connected to independent emergency volumes. Communications relays and local navigation beacons should operate before crewed descent. Robotic movers should position cargo and build prepared surfaces so that later landings do not blast dust and debris into existing equipment. The first site must be designed as a growing campus, not a collection of unrelated spacecraft.

The first real milestone is a surface system that works before crew arrival

A settlement program should demonstrate power generation, storage, communications, thermal control and at least one critical resource-production chain while nobody is present to improvise. Reliability becomes credible only when the surface can detect faults, isolate them, recover or enter a safe degraded state without depending on a crew standing beside the hardware.

Pedagogical calculation: how many successful landings for 100 useful tonnes on the surface?

If an illustrative architecture assumes 20 tonnes of useful landed payload per successful cargo landing, 100 tonnes requires at least 100 ÷ 20 = 5 successful landings. Planning one equivalent cargo as margin raises planned landed capacity to 6 × 20 = 120 tonnes. This is a teaching scenario, not a NASA mission architecture; its purpose is to expose how landing capacity multiplies operational events and risk.

Build local industry in order of criticality

The first workshops should not chase every consumer product. They should attack the items that most threaten survival when supply is delayed: seals, hoses, filters, structural repairs, electrical conversion, pumps, valves, simple machining and inspection. Local industry becomes strategic when it removes a single-point dependency from a life-support or mobility chain.

Stage 3: prove resource production without betting lives on it

MOXIE demonstrated that oxygen can be extracted from the carbon dioxide in the Martian atmosphere. That is a landmark result, but MOXIE was a small technology demonstration. A settlement needs industrial flow rates, compression, filtration, thermal management, storage and maintenance over years. Oxygen for breathing is only part of the demand; oxidizer for ascent vehicles can dominate the required mass.

Water extraction faces a similar scale gap. Excavating icy regolith, moving it into a sealed processor, heating it, separating contaminants and preventing refreezing are all power- and maintenance-intensive operations. For this reason, the first crews should carry strategic reserves and use local production to build margin progressively. “Living off the land” should begin as risk reduction, not as a single point of failure.

Stage 4: send the first crew as operators of a whole system

The first residents would need overlapping expertise rather than a set of narrow specialists. A physician who cannot assist with maintenance, or a power engineer who cannot support emergency care, creates brittle staffing. The crew must be able to isolate leaks, repair electrical systems, operate excavation equipment, grow food, conduct science, manage software and resolve conflict. No individual can master all of this, so documentation and cross-training become infrastructure.

Their operational tempo should be conservative. Early missions would spend far more time inspecting seals, cleaning filters, checking inventories and rehearsing emergencies than popular imagery suggests. Surface exploration matters, but the first achievement is a boring one: months in which every critical system remains understood and repairable.

Stage 5: survive the first missing shipment

A base is not permanent merely because its crew intends to stay. Permanence begins when the settlement can absorb a launch failure or a cargo delay without immediate evacuation. This requires distributed stores of food, water and oxygen; replacement components for pumps, valves and electronics; locally repairable structures; multiple power sources and protected seed and microbial stocks.

The correct metric is not complete self-sufficiency, which would be unrealistic for a small community. It is the length and severity of interruption the settlement can survive. At first that may be one missed delivery of non-critical goods. Later it should include loss of a major cargo vehicle, a greenhouse, a power unit or an entire habitat zone.

Stage 6: convert expedition infrastructure into settlement infrastructure

Repeated missions should not merely add beds. They should add capabilities. A machine shop reduces dependence on finished parts. A chemical plant turns local carbon dioxide and water into useful gases and feedstocks. A materials laboratory learns which bricks, glass, ceramics or metals can be produced economically. A larger medical suite increases the range of treatable conditions. Education and apprenticeship convert experience into durable local competence.

At this stage, the settlement’s geometry changes. No single pressure hull should contain all life-critical functions. Habitats, workshops, farms and stores are separated by fire and pressure barriers but connected by protected routes. Landing zones move farther away. Waste heat and water become resources in an integrated industrial ecology.

Stage 7: cross the threshold from base to city

A city appears when the community contains more than mission roles. Children are not required for the first definition of permanence, but long-term demographic continuity eventually becomes unavoidable. Schools, archives, courts, public spaces, cultural institutions and independent economic activity emerge. People arrive not only because a space agency assigned them, but because the settlement has work, relationships and a future of its own.

Political autonomy would probably develop gradually. Earth-based sponsors would retain contractual power as long as they provide essential transport and equipment. Yet communication delay and local risk already require operational autonomy. Over time, the people who bear the consequences of decisions will demand a larger role in making them.

Why Mars plans repeatedly look closer than they are

Human Mars plans have been proposed for more than seventy years. Von Braun produced technically detailed expedition concepts in the mid-twentieth century. Later strategies reduced crew size, used local propellant concepts or relied on reusable heavy launch vehicles. Each generation solved some previous constraints while revealing others. Transport mass is crucial, but it is not the only missing variable. Long-duration human health, dust toxicity, closed-loop reliability, landing very large payloads, surface power, medical autonomy and industrial maintenance remain coupled problems.

Schedules also depend on budgets, politics, test outcomes and launch-system maturity. Therefore, this guide deliberately avoids promising a date. A serious roadmap is defined by capability gates: demonstrate cargo landing, prove power, certify ice extraction, sustain life support, validate crew autonomy and only then increase dependence on local systems.

The realistic formula

Humans could colonize Mars by sending robots first, landing infrastructure before crews, building redundant power and shelter, producing water and oxygen locally without immediate dependence, selecting cross-trained teams, expanding repair and manufacturing capacity, and creating institutions able to govern a community separated from Earth. Every step is individually conceivable. The challenge is making all of them work together for decades.
